A614 junction improvements

Why are we upgrading the A614/A6097 Corridor?

  • reduce congestion and journey times
  • support economic growth
  • support the Strategic Road Network
  • support all road users – pedestrians, cyclists etc
  • improve safety, particularly at Mickledale Lane and Deerdale Lane junctions.

Proposed improvements

Ollerton Roundabout

  • enlarged conventional roundabout – 5 arms instead of 6
  • capacity increases
  • speed limit will be reduced on approaches
  • two toucan crossings
  • estimated cost £7.4 million
  • scheme requires third party land – Via will try to purchase all land by negotiation

Mickledale Lane

  • junction will be signalised
  • motorists exiting Mickledale Lane will see a big reduction in journey delay
  • estimated cost £2.6 million
  • scheme requires third party land – Via will try to purchase all land by negotiation
  • design currently focusing on local access to 4 properties and Limes Café.



Deerdale Lane

  • junction will be signalised
  • motorists exiting Mickledale Lane will see a big reduction in journey delays
  • hidden dip will be reprofiled as you approach junction
  • estimated cost £3.6 million
  • scheme requires third party land – Via will try to purchase all land by negotiation

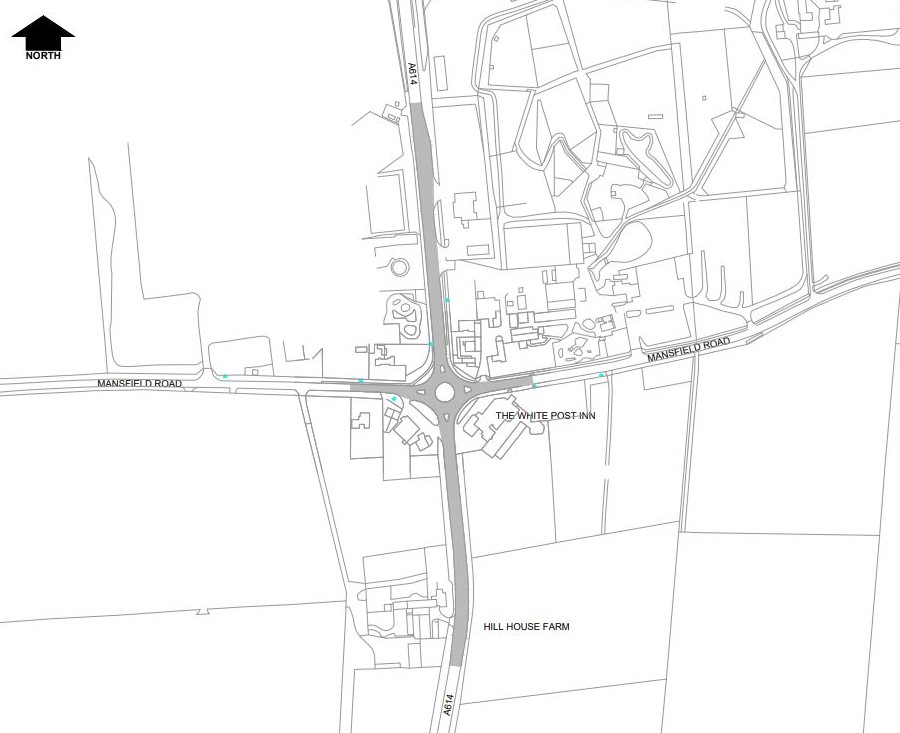

White Post Roundabout

  • maintenance Scheme – resurfacing and lining
  • estimated cost £100,000

Warren Hill

  • conventional roundabout constructed
  • estimated cost £3.8 million
  • scheme requires third party land – Via will try to purchase all land by negotiation

Lowdham Roundabout

  • enlarged conventional roundabout constructed
  • speed limit reduced to 30mph on all approaches
  • capacity increased
  • working with the Environment Agency and an opportunity to install some of their infrastructure if timings coincide
  • toucan crossing across Epperstone Bypass. Increases connectivity to village.
  • this scheme cannot make changes to Gunthorpe Bridge. This would need to be a separate project. DfT funding can only be spent on the 6 schemes listed
  • estimated cost £4.4 million
  • scheme requires third party land – Via will try to purchase all land by negotiation

Provisional next steps

  • public Consultation July 2019
  • planning Application submitted December 2019
  • compulsory Purchase Order March 2020
  • public Inquiry (if needed) Late 2020
  • Ollerton Roundabout construction (12-18 months) April 2021
  • Deerdale Lane construction (8 months) January 2023
  • Mickledale Lane construction (6 months) June 2022
  • Warren Hill construction January 2023
  • Lowdham Roundabout construction (12 months) Winter 2023
